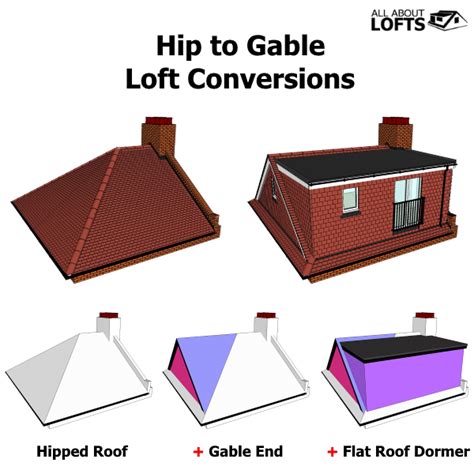

Hip to Gable Loft Conversion Timeline
So you're thinking about turning that hipped roof into a proper gable end. Honestly, it's one of the best moves you can make if you've got a semi-detached or detached place. Adds serious space, bumps up the value. But here's the thing – you need to wrap your head around the timeline. This isn't something you rush into blind. A typical hip to gable job runs about 8 to 12 weeks, give or take. But that really depends on planning stuff, structural needs, and whether your builder actually shows up when they say they will.
What is the typical duration for a hip to gable loft conversion?
Look, from the moment they start swinging hammers to when you're finally done, expect 8 to 12 weeks. That's assuming you've already got your planning permission and building regs sorted. The whole thing breaks down into stages. Design and planning eats up 2-4 weeks. Then structural prep, another 1-2 weeks. The main build? That's 4-6 weeks of noise and mess. Finishing touches take another 2-3 weeks. Weather's unpredictable. So are structural surprises. And supply chains? Forget about it. Always add a 2-week buffer. Seriously.
People Also Ask: Hip to Gable Loft Conversion Timeline
How long does planning permission take for a hip to gable loft conversion?
Planning permission usually takes 8 to 10 weeks from when you submit. But here's the kicker – a lot of these projects fall under Permitted Development. If you meet the criteria (volume limits, no weird balconies hanging out), you might skip full planning. Check with your local authority. Prior approval can be faster, maybe 6-8 weeks. Don't forget to factor in 2-4 weeks just for getting drawings and structural calculations sorted before you even submit anything.
What are the main stages of a hip to gable loft conversion?
Alright, so the stages go like this. First, you've got design and structural calcs – that's 2-4 weeks. Then planning and building regs approval, which is the long one, 6-10 weeks. After that, scaffolding and roof stripping – about a week. Steel beam installation and building the new gable end? That's 2-3 weeks of heavy work. Roofing and weatherproofing takes another 1-2 weeks. Then internal works: insulation, plumbing, electrics, plasterboarding – that's 2-3 weeks. Finally, finishing touches like flooring, windows, painting, and the final inspection – 1-2 weeks. So yeah, 8-12 weeks total for construction.
Can a hip to gable loft conversion be done in 6 weeks?
Six weeks? I mean, sure, some contractors might promise that. But they're probably lying. Or at least being wildly optimistic. Maybe if you've got a tiny, simple conversion with no dormer and minimal changes, and a really efficient team. But honestly, most projects need more time for steel deliveries, plaster to dry, and building control to sign off. Realistic minimum? 8 weeks. Don't let anyone rush you into thinking 6 is normal.
What delays the hip to gable loft conversion timeline?
Oh man, where do I start? Unforeseen structural issues are the big one – rotten rafters, dodgy foundations. Then there's bad weather, which can mess up roof work completely. Steel beam fabrication and delivery often take 2-4 weeks, so if you haven't ordered early, you're screwed. Planning permission complications or neighbours objecting? That'll slow things down. Contractor availability is another headache. And if you change the design halfway through? Forget about it. Best advice? Order those steel beams early. Have a backup plan for weather.
Hip to Gable Loft Conversion Timeline Breakdown
| Phase | Duration | Key Activities |
|---|---|---|
| Design & Structural Calculations | 2–4 weeks | Site survey, architectural drawings, structural engineer report, steel beam design |
| Planning & Building Regs Approval | 6–10 weeks | Submit planning application or prior approval, await decision, submit building regs |
| Scaffolding & Roof Preparation | 1 week | Erect scaffolding, remove roof tiles, strip existing felt, expose rafters |
| Structural Work (Steel & Gable End) | 2–3 weeks | Install steel beams, build new gable end wall, install ridge beam, form new roof structure |
| Roofing & Weatherproofing | 1–2 weeks | Install new roof felt, battens, tiles, flashing, and leadwork; ensure watertight |
| Internal Works (First Fix) | 2–3 weeks | Insulation, plumbing, electrical wiring, plasterboarding, window installation |
| Finishing & Final Inspection | 1–2 weeks | Flooring, painting, decorating, fit staircase, building control sign-off |
Expert Checklist for a Smooth Hip to Gable Conversion
- Order steel beams early – Lead times can be 3-4 weeks, so order as soon as structural calculations are approved.
- Check Permitted Development – Confirm if your project qualifies to save 6-10 weeks on planning.
- Hire a structural engineer – Essential for designing the new gable end and steel support beams.
- Plan for scaffolding – Scaffolding can take 1-2 days to erect and may need to stay for the entire project (8-12 weeks).
- Prepare for weather delays – Schedule roofing work in drier months (April-September) to avoid delays.
- Book building control inspections – Notify them at key stages (foundations, steel installation, insulation) to avoid rework.
- Budget for contingencies – Set aside 10-15% of the budget for unforeseen structural issues or material price increases.
Frequently Asked Questions
How much does a hip to gable loft conversion cost?
The cost typically ranges from £45,000 to £60,000 in the UK, depending on location, size, and complexity. This includes structural work, roofing, insulation, and finishes. Adding a dormer or en-suite bathroom will increase the cost.
Do I need planning permission for a hip to gable conversion?
Many hip to gable conversions fall under Permitted Development, but this depends on your property type, volume limits (40 cubic metres for terraced, 50 for detached/semi-detached), and whether you are in a conservation area. Always check with your local planning authority.
Can I live in my house during a hip to gable conversion?
Yes, but it can be disruptive. The main construction phase (2-3 weeks) involves noise, dust, and limited access to scaffolding. Many homeowners choose to move out for 4-6 weeks during the structural phase. Discuss this with your contractor.
What is the difference between a hip to gable and a dormer loft conversion?
A hip to gable conversion changes the sloping hip roof into a vertical gable end, increasing headroom and floor space. A dormer adds a box-like structure to an existing roof. Hip to gable is often better for semi-detached homes, while dormers are more common for terraced houses.
Short Summary
- Timeline: A hip to gable loft conversion typically takes 8 to 12 weeks from construction start to finish, with an additional 6-10 weeks for planning and approvals.
- Key Phases: The process includes design, structural work, roofing, internal first fix, and finishing; steel beam delivery is a critical path item.
- Delays: Common delays include weather, structural surprises, and planning complications; a 2-week buffer is recommended.
- Planning: Many projects qualify for Permitted Development, saving 6-10 weeks; always verify with local authorities.
